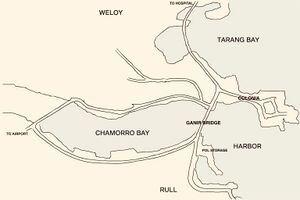

Ganir Bridge
The Ganir Bridge is the current name for a long-standing bridge connecting Colonia, the administrative center of Yap State, with Rull (sometimes “Rul”) on the southern side of Tomil Harbor. The fixed crossing at this location dates to the early German period.
The crossing originated as a low bridge or causeway and remained part of Yap’s road network under German, Japanese, U.S. military, and Trust Territory administrations. The name Ganir Bridge was adopted around 1970 following Trust Territory–era reconstruction. It is a steel-beam–supported concrete bridge approximately 75′ long and 28′ wide, carrying a ~22′ roadway with a ~5′ pedestrian walk across a tidal channel near Colonia.
Over more than a century, the crossing evolved from a colonial-era causeway into a modern bridge whose delayed reconstruction has become a test case for infrastructure planning and delivery in Yap State and the Federated States of Micronesia.
German Period (1898–1914)
1898: German colonial administration of Yap began several years after the Yap Conflict. German governance emphasized roads, harbor facilities, and communications associated with the cable station at Colonia.

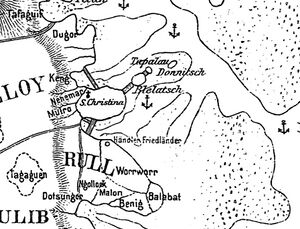

1901: A German-era map depicts a constructed crossing at the southern end of Tomil Harbor, aligned with the present Ganir Bridge and enclosing water on both sides consistent with Chomorro Bay.
Japanese Occupation and Mandate Period (1914–1945)
1914: Japan occupied Yap. Roads, paths, and causeways were treated as established infrastructure, with accounts assuming continuous overland travel around Yap Proper.
1940: ¥30,000 was appropriated for highway construction on Yap, directed toward road and crossing improvements.

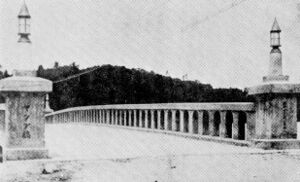

1944: U.S. Navy Civil Affairs reporting described Yap as having an “excellent network of highways” and noted that “at the town of Yap on Tomil Harbor a causeway crosses the arm of the sea from the cable station southwestward” (OPNAV P22-7).
Postwar Administration and TTPI Reconstruction (1945–1970)
1945: Japanese-built roads and causeways remained in use following the end of hostilities; no destruction of the Colonia–Rull crossing was reported.
1960s: Trust Territory public works programs upgraded Yap’s road system. The Colonia–Rull causeway or low bridge was rebuilt into a more permanent structure.

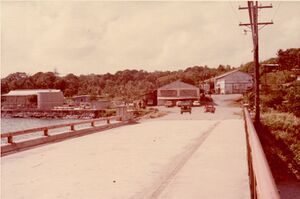

1970: The newly re-completed crossing became formally known as Ganir Bridge
Modern Use and Infrastructure Challenges (1970s–2000s)
1970s–1980s: Ganir Bridge carried daily vehicular traffic between Colonia and southern Yap. Maintenance was routine; no full replacement occurred.
1990s: Structural limitations and deterioration were identified, including load and safety concerns.
Early 2000s: Rising traffic volumes increased the bridge’s importance and exposed its role as a single point of failure in Yap’s road network.

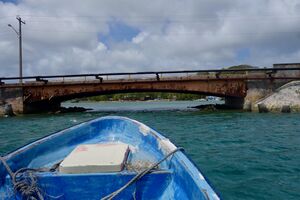

2006: Inspections document severe corrosion and section loss in primary steel members beneath the deck, independent of traffic demand or alignment constraints. Yap State initiated Compact-funded replacement planning, evaluating alternative designs with revised superstructure and substructure configurations and proceeding with full replacement of the original bridge.
Governance, Funding, and Procurement Context
Under the Compact of Free Association, U.S. infrastructure assistance is provided to the FSM national government through sector grants. Project selection, compliance, and disbursement are managed nationally, with funds released to states on a project-by-project basis.
Ganir Bridge predates modern design standards and was maintained for decades through periodic repairs rather than full replacement. National infrastructure planning places road and bridge projects from all states within a single priority framework.
Major FSM infrastructure projects are procured through open international competitive bidding governed by national law and multilateral development partner requirements. These processes are separate from defense and security arrangements under the Compact.
Recent Planning Efforts and Public Controversy (2010s–Present)
2010s: Infrastructure plans and donor assessments classified Ganir Bridge as structurally deficient and prioritized it for replacement.
2023: Ganir Bridge was identified as a priority project in Yap State’s Annual Infrastructure Plan developed in coordination with national Compact 3 planning.
2023: President David W. Panuelo referenced “the $8 million Ganir Bridge” in his State of the Nation Address, citing ongoing environmental review and design work.
2024 (January): In his State of the State Address, Yap's Governor Charles S. Chieng identified Ganir Bridge as an ongoing infrastructure priority and acknowledged delays involving private contractors.
2024 (June): Yap State cabinet briefings reported that the Ganir Bridge project faced financing and Compact-related administrative (CTIS) issues.
2024 (August): Yap State officials met with the Asian Development Bank to review ongoing infrastructure projects, including Ganir Bridge, and to discuss project requirements and implementation processes.
2024 (September): Yap State announced that groundbreaking for the Ganir Bridge project was scheduled for December 2024, following agreement with the FSM National Government.
2024 (December): The Governor of Yap formally urged the FSM National Government to act on delayed infrastructure projects, noting that more than 100 days had passed since bidding closed for the Ganir Bridge without further action.
2025: Ganir Bridge remained listed as a priority replacement project in Yap State infrastructure plans, with preparatory work continuing to align the project with Asian Development Bank financing requirements.
